There is a persistent belief on sites that concrete finish is a function of the mix. Get a good batch, vibrate it well, and the column comes out clean. It is mostly wrong. By the time the mixer arrives, the finish has already been set — by whoever built the formwork three days earlier.
What honeycombing actually costs
Honeycombing is the voided, gravelly patch you find when you strike a column. The usual explanation is poor compaction. More often it is grout that escaped through an open joint in the formwork, leaving the aggregate behind with nothing to bind it.
Remediation is not cheap. You have to cut out to sound concrete, expose and clean the reinforcement, check whether the loss of section matters structurally, and patch with a repair mortar that will never quite match the surrounding colour. On a fair-faced column in a hotel lobby, that patch is visible for the life of the building. On a structural member, you may be asked to prove the repair. Both outcomes cost more than doing the formwork properly would have.
The checks we make before any pour
Joints. Every panel-to-panel and panel-to-kicker joint gets inspected. A 2mm gap will bleed grout under vibration. Foam tape or a timber fillet closes it. This is a ten-minute job that saves a week.
Kickers. A 75–100mm kicker cast with the slab gives the column formwork something accurate to sit against and seals the base. Sites that skip kickers to save a day almost always lose that day to grout loss at the column foot.
Tie and clamp spacing. Column clamps get closer together towards the bottom, because that is where the pressure is highest. Evenly spaced clamps up a 3m column are a sign nobody calculated the pour pressure. We space to the pour rate we intend to use, and then we hold the crew to that rate.

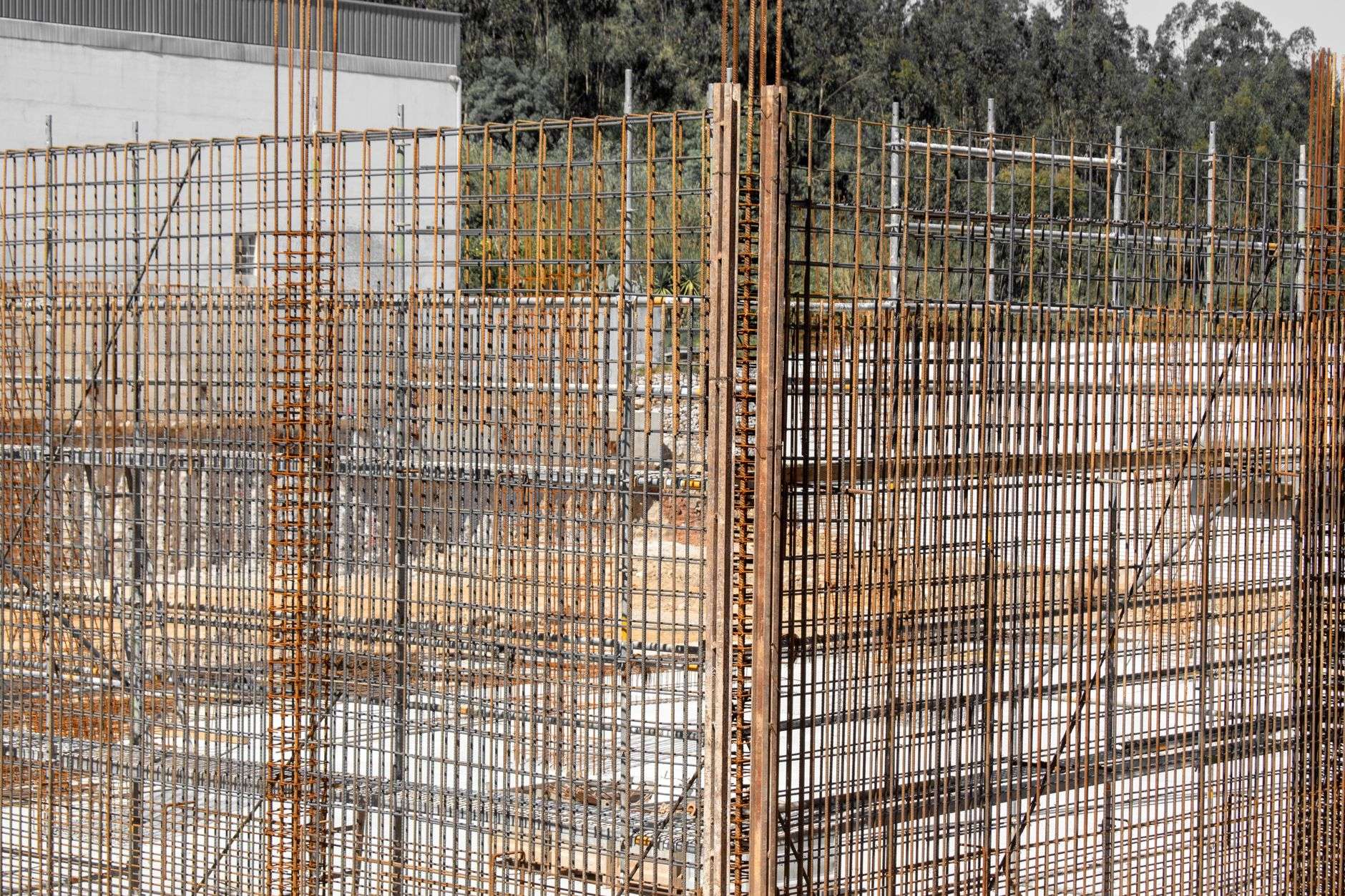

Release agent. Applied thinly and evenly, to clean formwork, before the reinforcement is fixed — not sprayed over the cage afterwards, which contaminates the bond between steel and concrete. Old sump oil is not a release agent, whatever the storeman tells you.
Plumb and line. Checked twice: once when the formwork is set and propped, and once immediately before the pour, because props get knocked. A column 15mm out of plumb at first-floor level compounds all the way up the building and eventually becomes somebody’s blockwork problem.
Pour rate is part of the formwork design
Formwork pressure depends on how fast you fill it. Pour a 3m column in ten minutes and the pressure at the base approaches full hydrostatic. Pour it in three lifts with vibration between and the lower concrete begins to stiffen and carry itself.
We set a pour rate at the pre-pour briefing, and the ganger holds it. This is the single most common thing that goes wrong on sites we are asked to take over: everybody wants the pour finished before the rain, so the rate goes up, and the formwork blows.
Striking and curing
Vertical formwork to columns and walls can usually come off after 24–36 hours in Ugandan temperatures. Soffit formwork to slabs and beams cannot — props stay in until the concrete has the strength to carry itself and whatever is stacked on it, which in practice means 7 days minimum with backpropping, and 14 for anything spanning far.
Strike early and the member deflects permanently. You cannot take that deflection back out.
And then cure. Hessian kept wet, or a curing membrane, for at least seven days. A column that dries out in the first 48 hours will craze at the surface and never reach its design strength, and no amount of good formwork will rescue it.
The point
Formwork is treated as temporary works and priced accordingly. It is in fact the mould that determines the permanent works, and the crew building it deserves the same scrutiny as the crew fixing the steel.
